. v2027 Help

How to Receive Goods from Purchase Order

1. Overview

The Goods Receiving process is used to record goods delivered against an approved Purchase Order.

After a Purchase Order has been approved and the vendor delivers the items, the receiving user records the actual items received, including:

  • Store

  • Batch

  • Quantity

  • Expiry date

  • Other required receiving information

The receiving process ensures that the physical goods delivered by the vendor are correctly recorded in Inaya and, where Procurement–Inventory integration is enabled, added to the selected store's inventory.

2. Why Is Receiving Purchase order Important?

Goods receiving confirms that the goods ordered from the vendor have actually been delivered.

It helps to:

  • Confirm delivery against the Purchase Order.

  • Record the actual quantity received.

  • Track batches and expiry dates.

  • Update store inventory.

  • Identify shortages or excess deliveries.

  • Maintain accurate procurement records.

  • Provide traceability between the Purchase Order and inventory.

3. Requirements to Receive Goods from purchase order

Before receiving goods, ensure that:

  1. The Purchase Order has been approved or passed without approval.

  2. The vendor has delivered the goods

  3. The correct Purchase Order is available.

  4. The receiving store is known.

  5. The items delivered can be identified.

  6. Batch numbers are available where batch tracking is required.

  7. Expiry dates are available for applicable products.

  8. The user has permission to receive goods.

  9. Required inspection has been completed where inspection is configured.

4. Step-by-Step Guide

Navigate to

Step 1: Open purchase → Purchase order

Po navigate main menu po

Purchase order → Select purchase order with status waiting for delivery and tap it to open

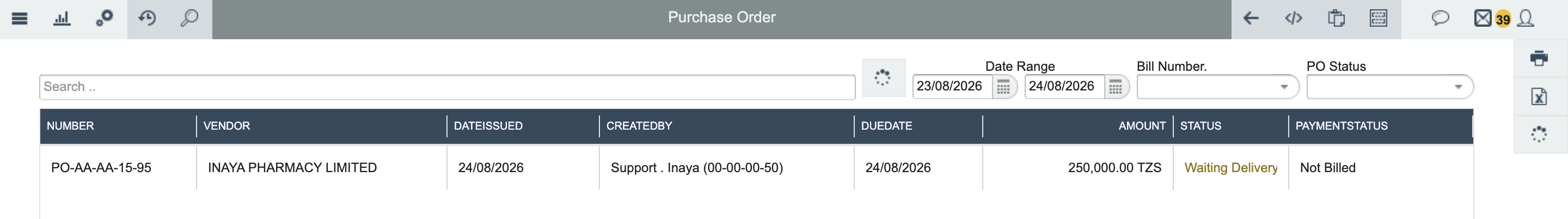

Approval po waiting for delivery

Step 2: Select receive in 1 followed by tap the item you want ro receive in 2

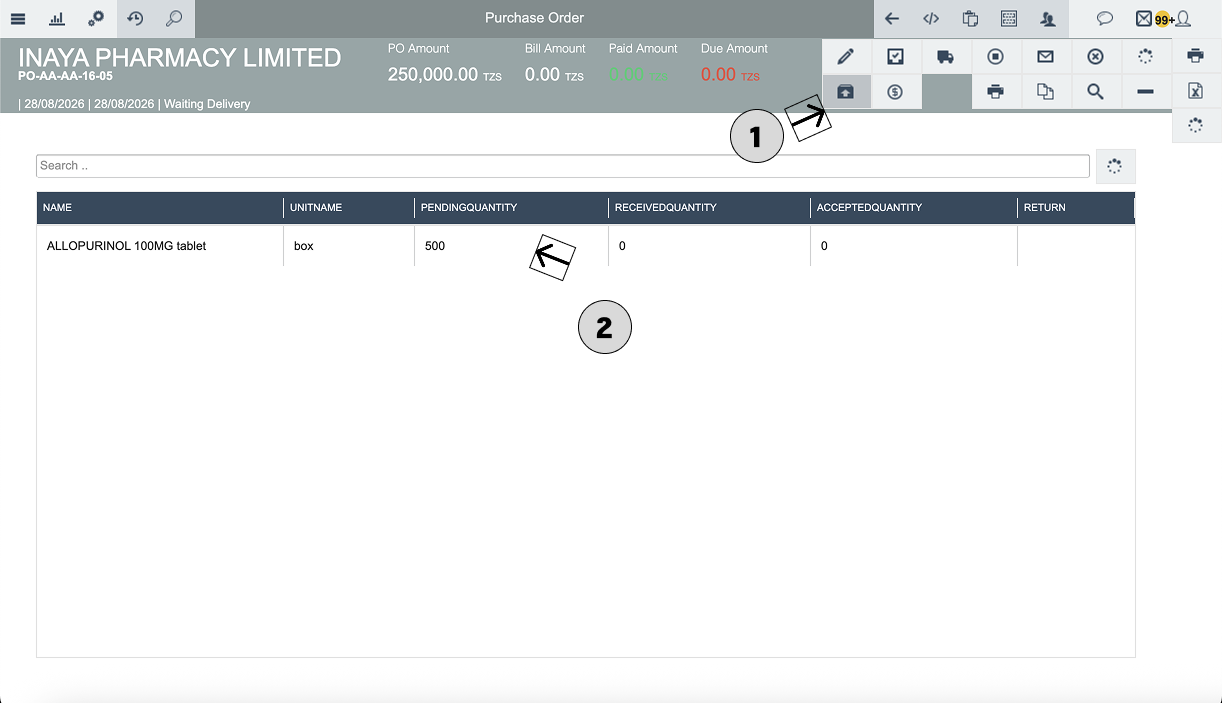

Po waiting for delivery1

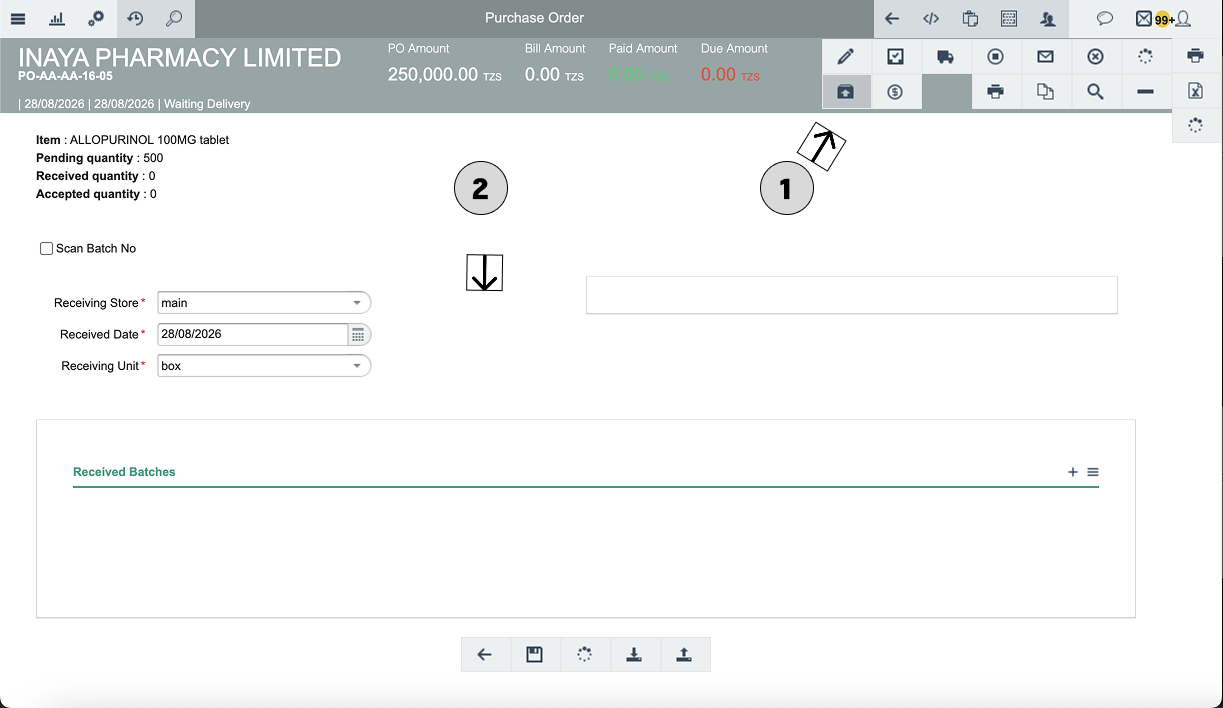

Step 3: Select the Purchase Order item to open it

Po open to recieve

Step 4: Select the Store

Select the store where the delivered goods will be received as well as unit.

Procurement select store

Step 5: Use the Plus (+) Icon

On the receiving screen, use the plus (+) icon on the right side of the item to add the receiving details.

The plus action is used to enter information for the batch being received.

Po use plus icon

Step 6: Add the Batch

Enter the batch number printed on the physical product.

Po batch add

If the same item is delivered in multiple batches, add each batch separately.

Multiple Batch Example

Item

Batch

Quantity

Total Received

ALLOPURINOL 100MG

Batch A

300 Boxes

ALLOPURINOL 100MG

Batch B

200 Boxes

ALLOPURINOL 100MG

Total

500 Boxes

500 Boxes

Step 7: Enter the Quantity

Enter the actual quantity physically received for that batch.

Example:

Po add quantity

The receiving quantity should match the physical quantity delivered.

Step 8: Enter the Expiry Date

Enter the expiry date shown on the physical product.

Po add date

Do not guess the expiry date. Verify it directly from the product packaging.

Step 9: Save the Batch

Save the batch information.

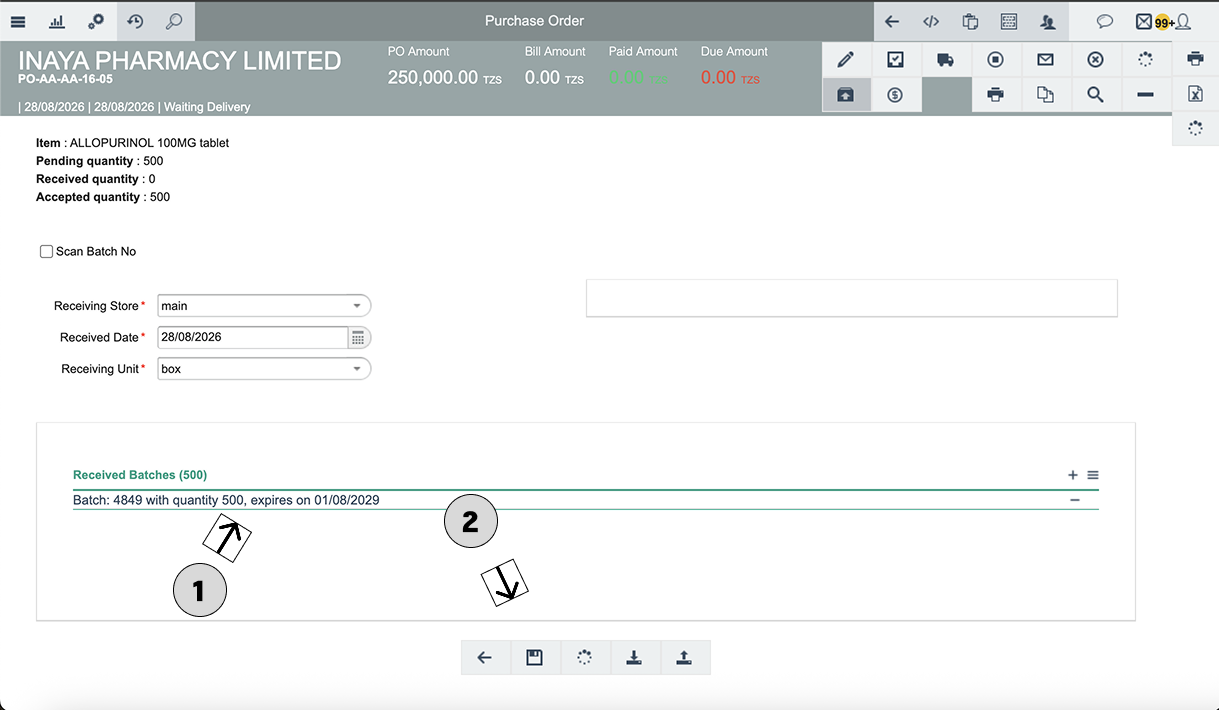

Po saved batch and confirm

Step 10: Review All Received Items

After adding the batch information, review the receiving document which later we will confirm in 2.

Check:

  • Item

  • Batch

  • Quantity

  • Expiry date

  • Store

  • Total received quantity

Make sure the recorded quantities match the physical delivery.

Po saved batch and confirm

Step 11: Confirm the Entire Receiving

After all items and batches have been entered and saved, Confirm the complete receiving transaction.

This final confirmation records the Purchase Order receiving.

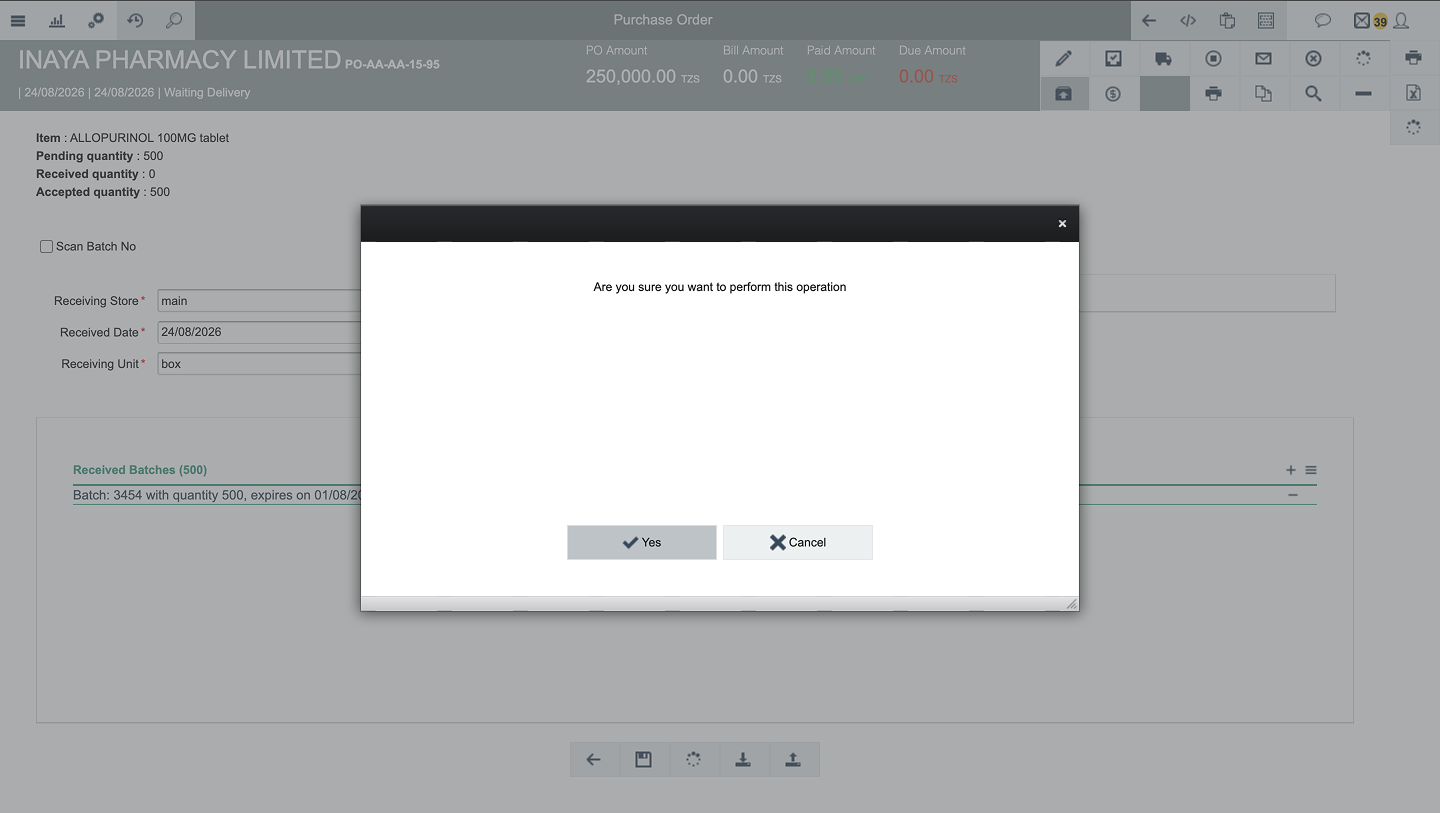

Po confirm item

6. What Happens After Confirming the Receiving?

Once the receiving is confirmed, Inaya records the received quantities against the Purchase Order.

For the example:

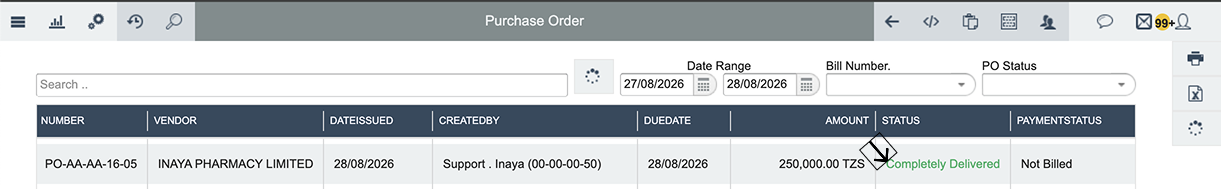

Po completely delivered2

The Purchase Order can show:

Completely Delivered

where the full ordered quantity has been received and accepted.

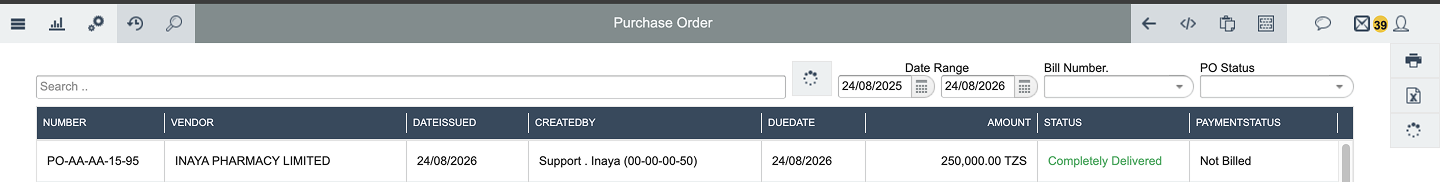

Po with approval delivered

7. Receiving Multiple Batches

An item may arrive in more than one batch.

For example:

Item

Batch

Quantity

Expiry Date

ALLOPURINOL 100MG

ALLOP001

300 Boxes

06/2028

ALLOPURINOL 100MG

ALLOP002

200 Boxes

08/2028

Total

500 Boxes

Each batch should be added separately using the + icon.

9. What If the Receiving Cannot Be Saved?

If you are unable to save the receiving transaction, first check whether the required inspection has already been completed.

Some receiving workflows require inspection before the goods can be fully received.

If the inspection has not been completed, complete the required inspection first and then return to the receiving process.

Common Cause

Receiving cannot be saved because inspection has not been completed.

Solution

  1. Check whether the Purchase Order requires inspection.

  2. Open the relevant inspection process.

  3. Complete the inspection.

  4. Save the inspection result.

  5. Return to Receiving.

  6. Add the batch, quantity, and expiry date.

  7. Save and confirm the receiving.

10. Common issue in receiving Purchase order

No.

Problem

Possible Cause

Solution

1

Purchase Order is not available for receiving

PO has not been approved or is not ready for receiving.

Verify the PO status and approval status.

2

Cannot select the store

Store configuration item is not added to stock

Verify that the user has access to the required store.

3

Cannot add batch

The + action was not selected or batch information is missing.

Click the + icon beside the item and enter the required batch details.

4

Receiving cannot be saved

Required inspection has not been completed.

Complete the required inspection and return to receiving.

5

Quantity is incorrect

Physical quantity differs from the PO.

Count the delivered goods and enter the actual received quantity.

6

Wrong expiry date entered

Expiry date was entered incorrectly.

Verify the physical packaging and correct the expiry date.

7

Multiple batches are not recorded correctly

All quantities were entered under one batch.

Add each batch separately using the + icon.

9

Wrong store received the stock

Incorrect store was selected.

Verify the selected store before confirming the receiving.

10

PO still shows pending quantity

Not all ordered quantities have been received/accepted.

Review the pending quantity and receive the remaining items if delivered.

28 August 2026
